here’s some past work you might really dig

with tyler krage consulting

city of rolling meadows bears stadium transportation plan review

2025

The one that kicked off this whole shebang, we’re on contract to review of the Chicago Bears Transportation Plan on behalf of the neighboring community of Rolling Meadows, IL. We’re pleased to be on this project as a sub-consultant to CBBEL, and are excited to start review of this plan to provide the best value back to Rolling Meadows!

with others

city of Inglewood sofi stadium transportation plan and signal timing

2019-2021

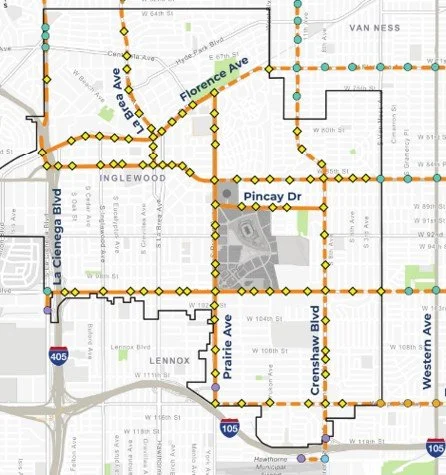

While at Alliant Engineering, I took part in developing the Sofi Stadium Transportation Management Plan in Inglewood, CA. I played an integral part in the volume routing analysis as well as conducted the signal retiming and implementation for 140+ signals to utilize 3 event timing plans (an inbound, outbound flush, and outbound low) and 6 normal-day timing plans.

Project Contact - Peter Puglese, Inglewood City Traffic Engineer

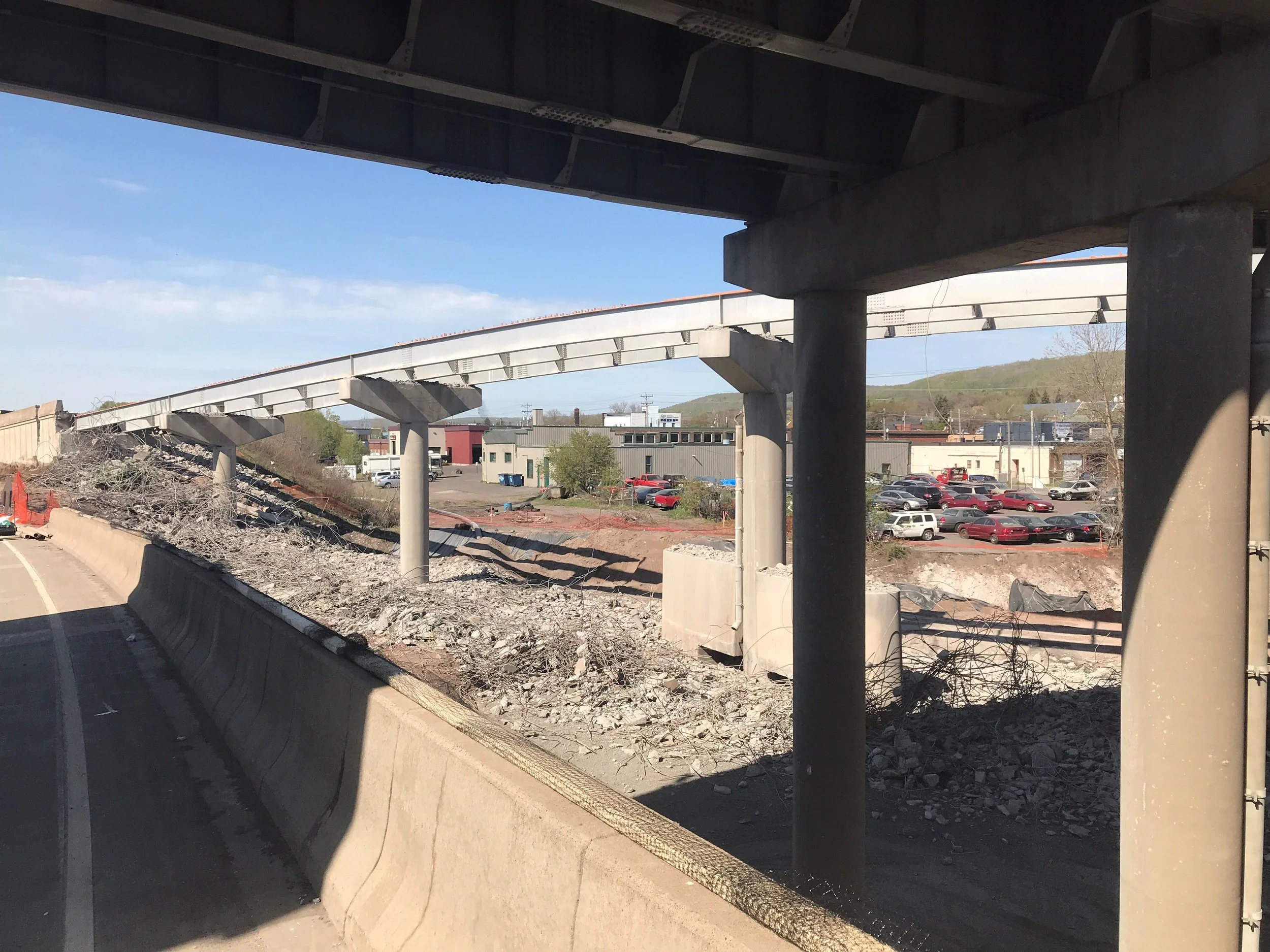

Mndot Twin ports Interchange Detour traffic signal timing

2019-2021

While at Alliant Engineering, I took part in developing signal timing detour plans for MnDOT’s Twin Ports Interchange work in Duluth, MN, a project that involved reconstructing a major regional connection in the Duluth area, and its impacts involved major traffic rerouting through areas not necessarily built to handle that capacity.

Project Contact - Mike Anderson, Alliant Engineering VP-Traffic and Business Dev.

operations just before implementing split-phased operations on the cross-street and access management

dakota county csah 38 & CR 5 detour signal timing

2025

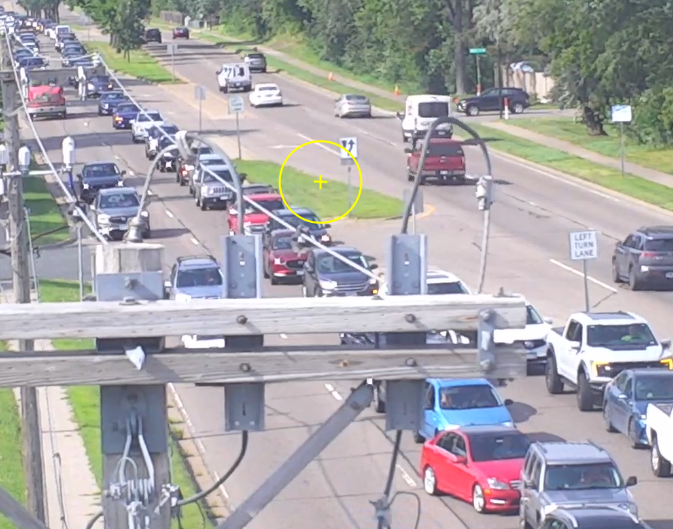

Even recently here at Dakota County, I was able to scratch the unique signal timing itch. When MnDOT rebuilt the Burnsville Parkway bridge, their detour routed 500+ extra vehicles per hour to a left-turn movement of a County signal; I threw the kitchen sink at the signal to get it to work. We utilized Twice Per Cycle Left Turns, upstream half cycle metering, access management, and clever split-phased reconfigurations to make it work safely and efficiently as possible for the 7 months it was in effect. If that sounds neat (or even if it’s Greek to you), reach out, I’d love to chat about it.

city of chicago various signal timing work

2021-2024

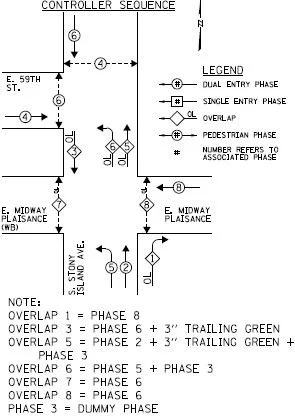

In my time at the City of Chicago DOT, I signed off on 120+ signal designs and 300+ signal timing plans. These varied from basic 2-phase signals to intricate six-legged, combined intersections on one controller, and other weird configurations. A vast amount of these involved conversion from interval to NEMA phasing, which required lots of signal tricks to work correctly. Some of my favorites involved retiming the Broadway/Sheridan corridors in Uptown (30 signals), Stony Island on the Southside (21 signals), Ashland from Pilsen to North Center (56 signals), the Stony Island/79th intersection, and temporary detour timing around the Obama Library where we used to dummy phases and overlaps to handle massive reroutes of traffic (and we tricked Synchro into modeling it as a 4-ring signal).

Project Contact - Abraham Emmanuel, CDOT Traffic Safety Deputy Commissioner

city of minneapolis various signal timing

2013-2016

The first city I fell in love with and the place I currently reside, I’ve been really lucky to take part in helping make the Minneapolis’ signal timing the best it can be. When with Alliant Engineering, I took part in some of the following signal efforts:

  • Implementing the Downtown network’s signal timing

  • Developing the model and optimizing signal timings for Northeast

  • Implementing snow plan timings in South Minneapolis

  • Aiding in model and timing updates for the US Bank Stadium

  • Modeling of 1st Ave and Blaisdell bikeway signal operations

  • Aiding in modeling and analysis of 3rd Avenue, 8th St, and 4th Ave reconstruction efforts in Downtown

  • Various other small scale on-call work

Project Contact - Mike Anderson, Alliant Engineering VP-Traffic and Business Dev.
